This guide walks through building a cross-connect through a fiber splitter in Vision — connecting an OLT PON port, through the splitter, out to your patch panel ports.
The example below uses a 1x4 splitter on Card 2, PON 1. The same steps work for any splitter size. The only thing that changes is how many circuits you build: always splitter size + 1 (one input, plus one output per leg). A 1x4 needs five circuits; a 1x8 needs nine.
You don't have to build a splitter out completely in one sitting. Building incrementally is fine — just always finish at least one full input-to-output connection before you stop.
Table of Contents

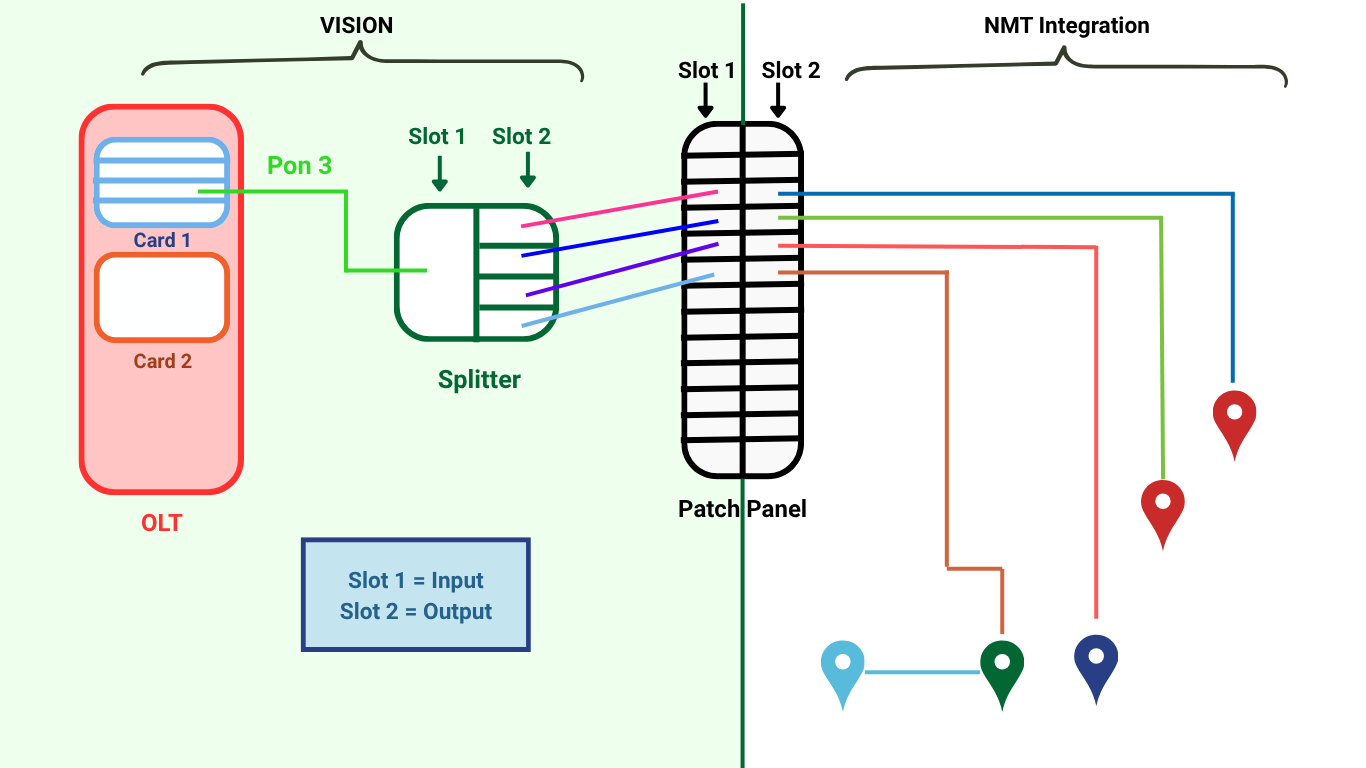

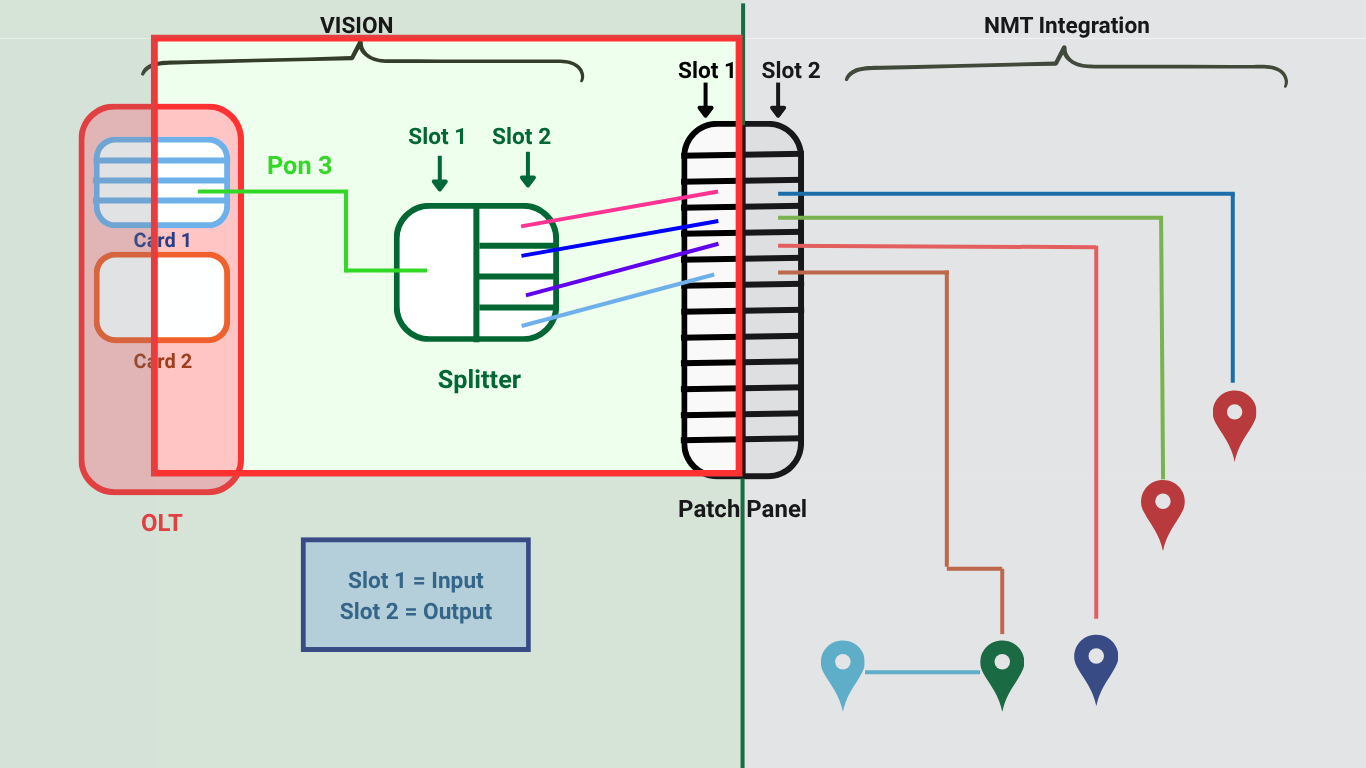

The diagram below shows the overall fiber path from the OLT, through the splitter and patch panel, and out toward the final service locations.

On the left side of the diagram, the Vision-managed portion includes the OLT PON port, the splitter, and the patch panel inputs. In this example, PON 3 from the OLT connects to a splitter, such as a 1x4 splitter. The splitter outputs are then connected to the desired input ports on the patch panel.
The right side of the diagram represents the NMT integration side. Once the connection reaches the patch panel outputs, NMT handles the remaining path from the patch panel out to the associated homes or service locations.
In this setup, Slot 1 represents the patch panel input side and Slot 2 represents the patch panel output side. The selected Slot 1 inputs should match the Slot 2 outputs that are already connected to the intended field locations. These output connections are typically already determined by the physical patch panel wiring, service area design, or existing fiber assignments.
The second diagram highlights the specific portion covered by this documentation. The red box shows the Vision-managed cross-connect work: connecting the OLT PON port to the splitter, then connecting the splitter outputs to the correct Slot 1 inputs on the patch panel. This ensures the Vision side of the connection lines up with the NMT-managed outputs that continue to the homes.

First, check whether you already have an open splitter to use.

If an unused splitter of the right size appears (You can check if it is unused by opening the hardware and checking if there are circuits tied or not), move it to the warehouse you're working in, then skip to Step 3:

If none are available, continue to Step 2.

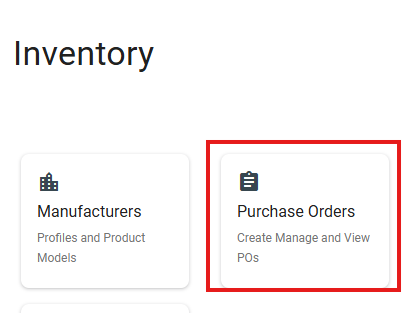

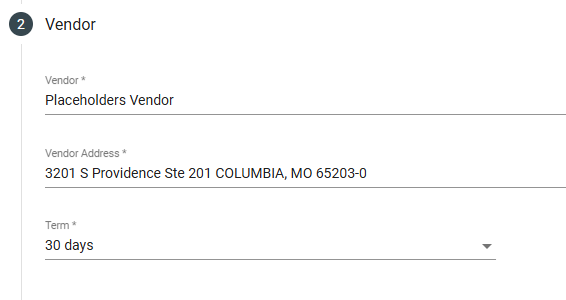

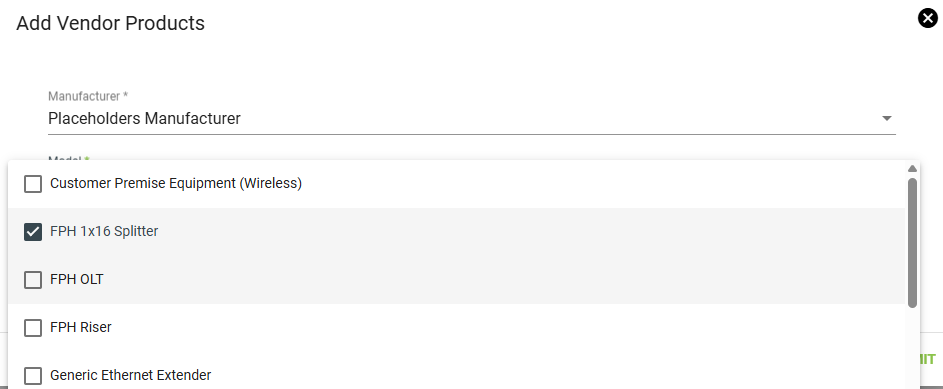

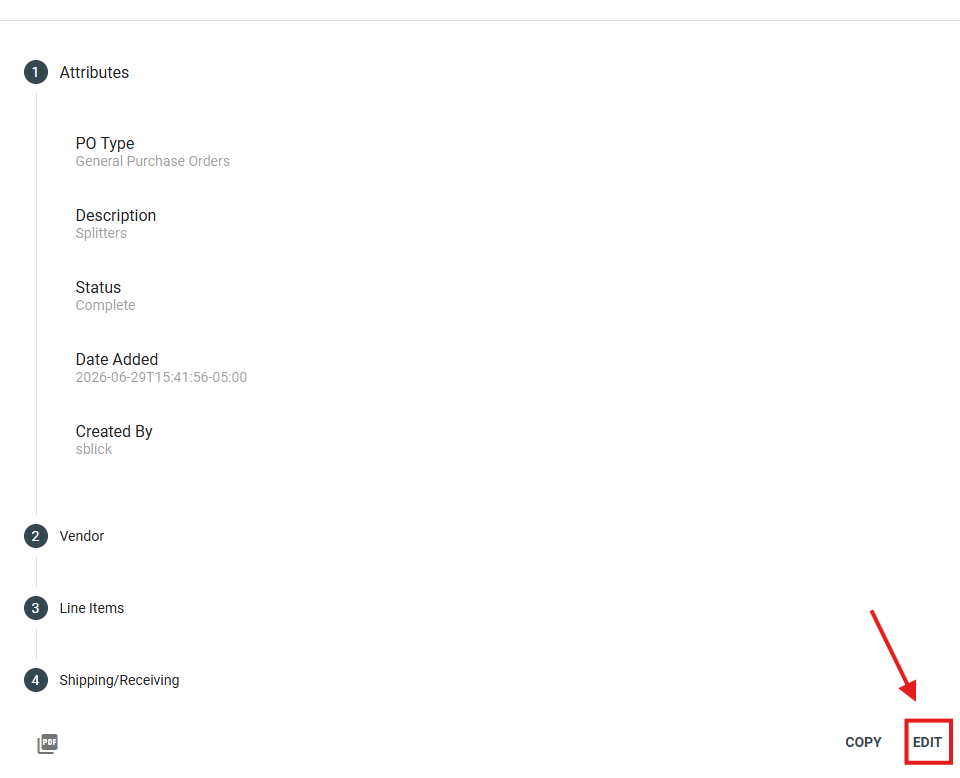

Skip this step if you already have a splitter ready in your CO.

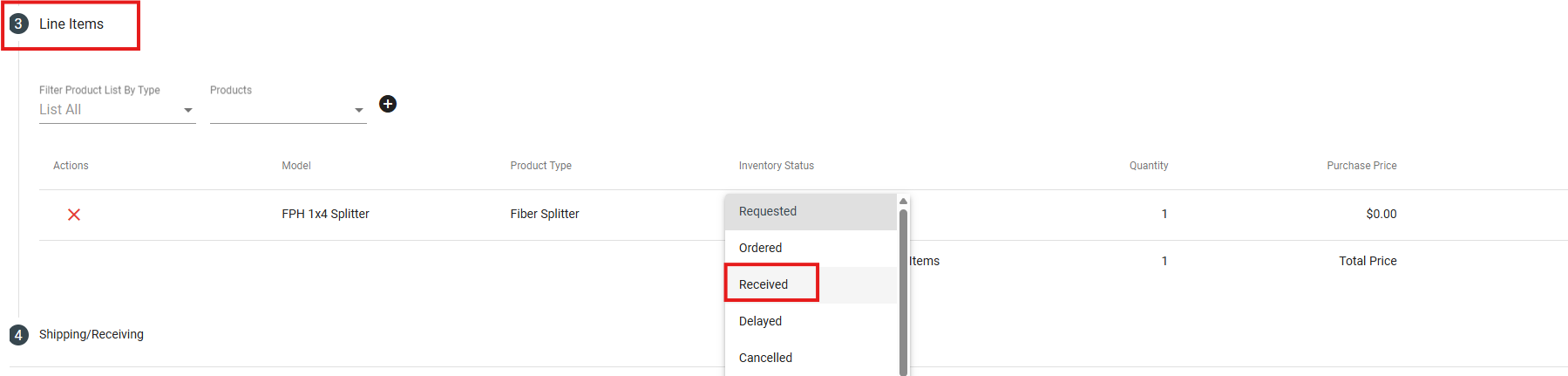

Completing the purchase order creates the splitter hardware in your warehouse.

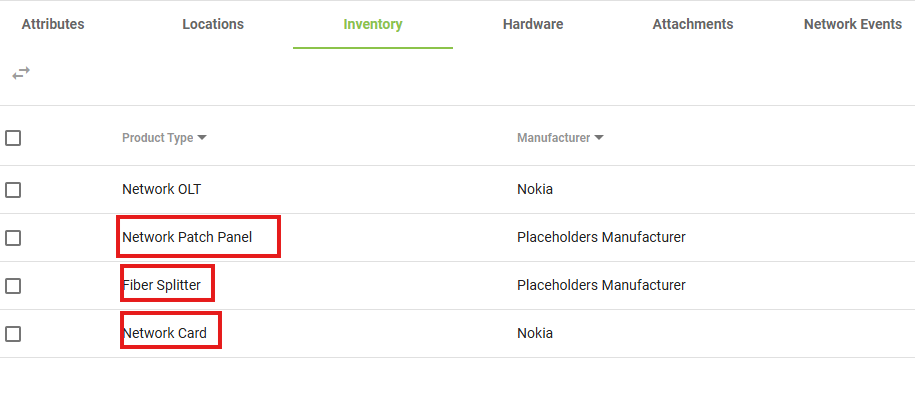

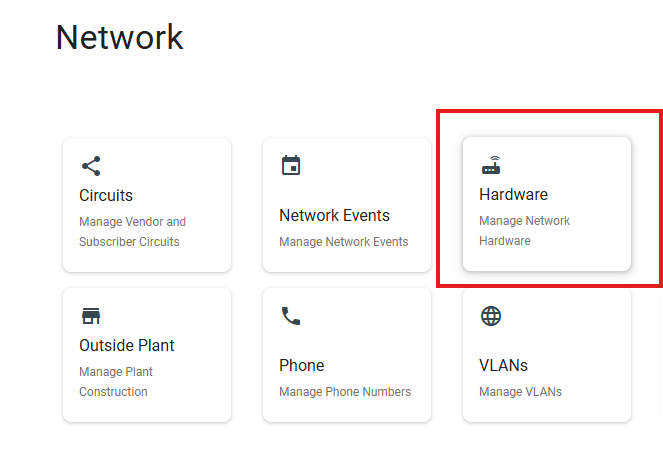

Navigate to your warehouse (Inventory > Warehouse) and open the three pieces of hardware involved in the cross connect:
Ctrl + click each hardware ID to open it in its own tab.

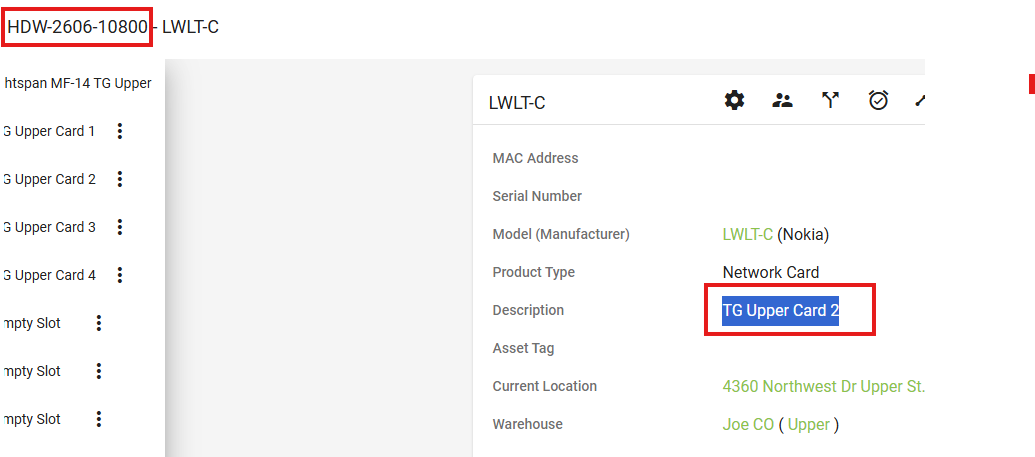

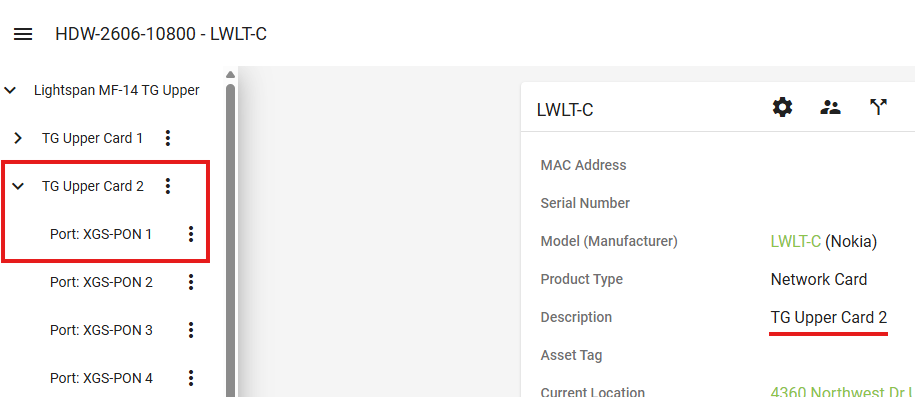

One note on the OLT: if your OLT has cards built into it, click into the individual card to get that card's hardware ID. In this example we're working on PON 1 of Card 2, so open Card 2 — that's the network card your PON ports live on.

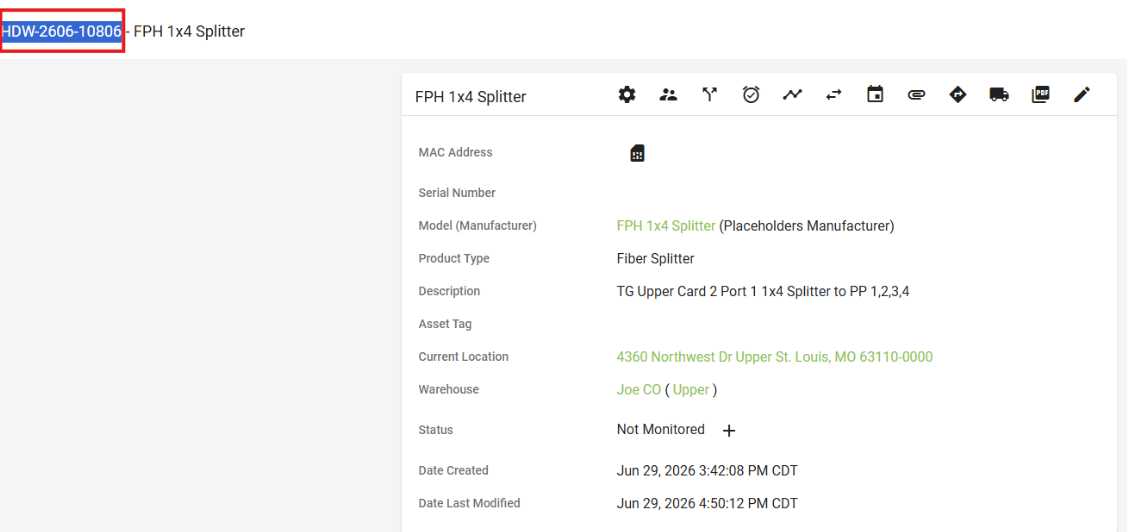

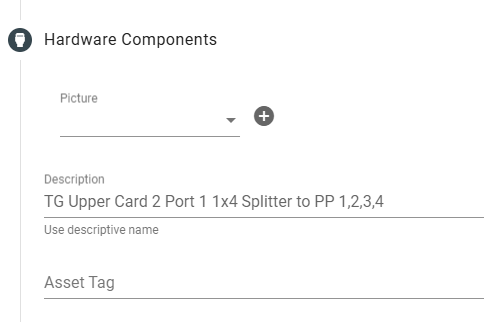

Good labeling means anyone can look at this splitter later and immediately see what it connects to — the OLT port it comes from and the patch panel ports it feeds.

Now anyone reviewing this splitter can see exactly which patch panel ports it's meant to reach.
You'll build one circuit per connection. For a 1x4, that's five: one input circuit (OLT to splitter) and four output circuits (splitter to patch panel).

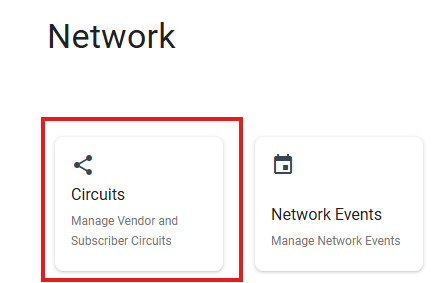

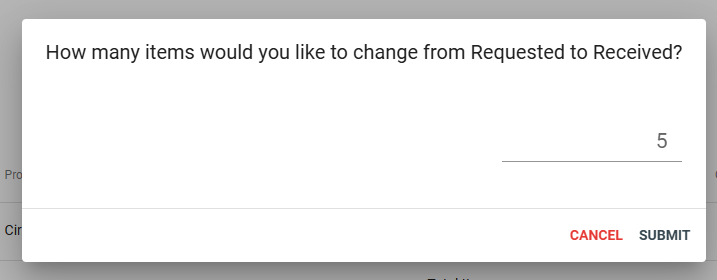

If you have enough unused fiber circuits, Ctrl + click each one to open its receiving screen in its own tab — five for a 1x4 — then continue to Step 7. If you don't have enough, build them with a purchase order in Step 6 first.
Circuits use a different purchase order type than hardware.

Once that's done, repeat Step 5 (or refresh that tab) to open the relevant circuits.
Before you start receiving circuits, it helps to understand how Vision models a splitter's ports.
The ports are grouped into two slots.

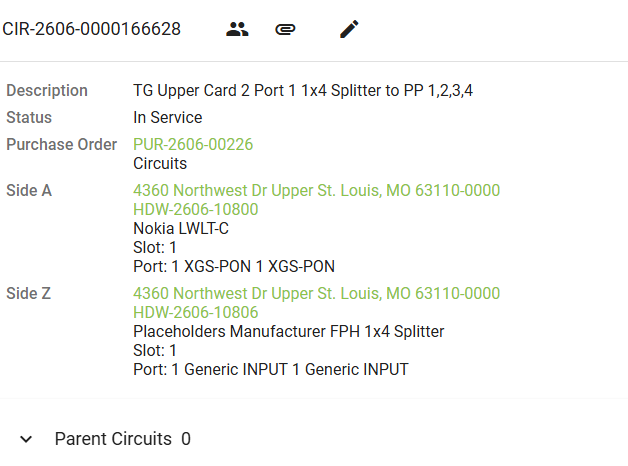

This is always the case. So your single input circuit lands on Slot 1, and every output circuit lands on Slot 2. Keep that rule in mind through the next two steps.

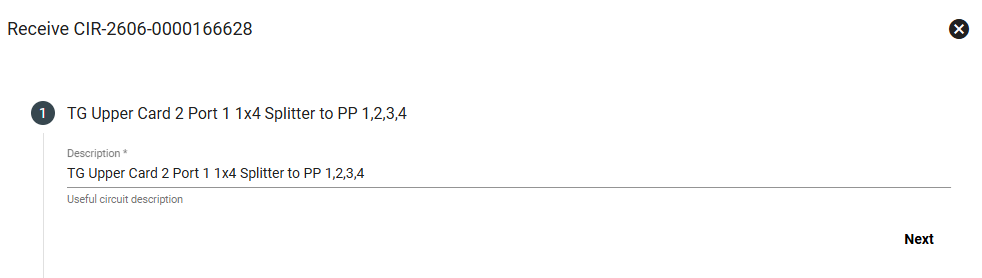

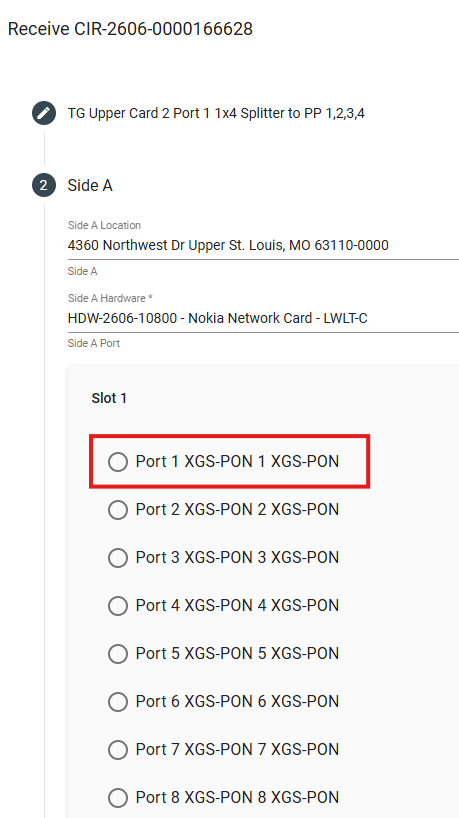

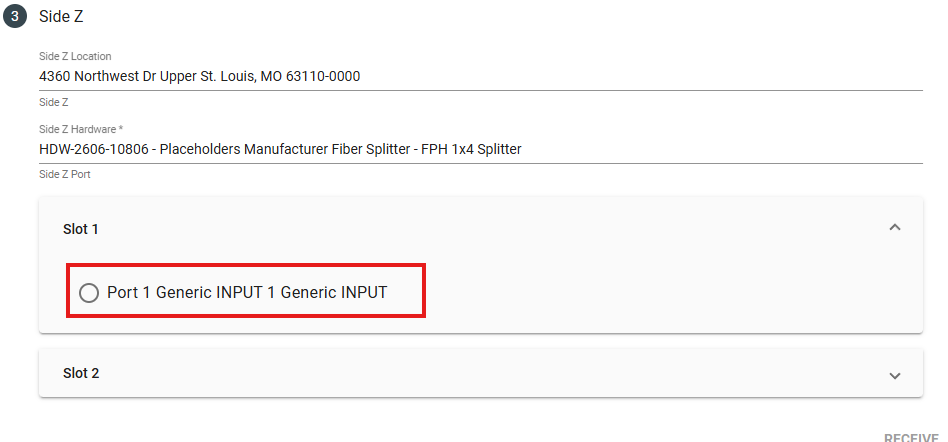

With your receiving tabs open from Step 5, start with the input circuit, which connects the OLT to the splitter's input:

The input circuit is done. You can close the tabs you're finished with (the OLT tab, this circuit's tab, and the circuit list tab) to keep things clean and free up memory.

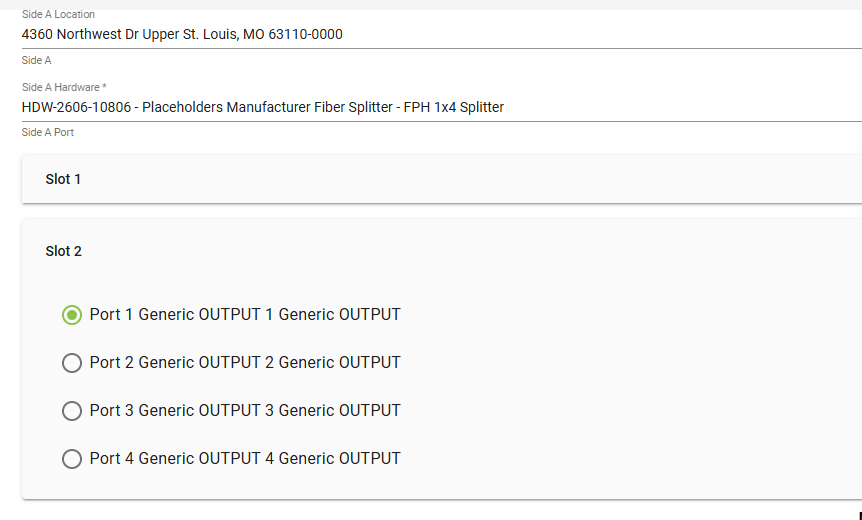

Now build the four output circuits across your four remaining tabs. In this example, each output port on the splitter maps to one input port on the patch panel, in order — output 1 to input 1, output 2 to input 2, and so on.

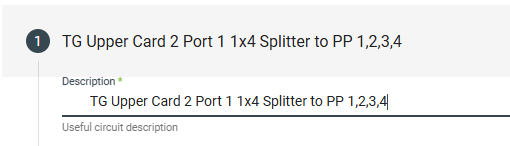

First, set each description. Paste the splitter description and add which patch panel port that circuit goes to — In this example, Port 1, Port 2, Port 3, Port 4. (Ctrl + Tab moves you to the next tab.)

Then complete each one the same way:

Repeat for all four output ports. When the last one is finished, close the patch panel tab.

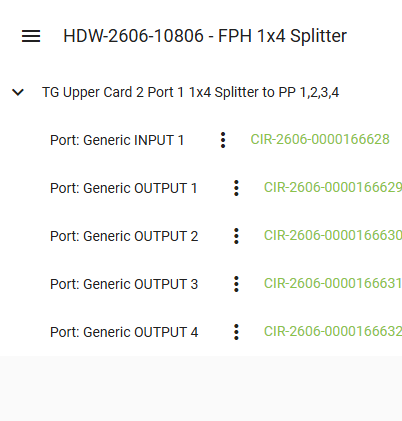

Refresh the splitter tab. Open the Circuit menu next to its hardware ID and expand it — you should see the splitter fully cross-connected, with the input and all four outputs in place.

As noted up top, it's best practice to complete a full splitter at a time when you can, but stopping after any complete input-to-output leg is fine.
As mentioned at the start, your patch panel came in from an imported drop. Right now that drop won't be valid, because the cross-connects didn't exist yet when it was imported. There are two ways to fix this.
Option 1 — Re-import (best for workflows that haven't been installed yet)
If possible, open the installation workflow and find the task with your Drop Construction Map. Open the map and select re-import. This updates the circuit, and it will then follow your new cross-connect circuits back to the source.
Option 2 — "Walking the circuit back" (quickest; best for already-installed workflows)
